McEwen Inc.

Operations · San Juan, Argentina

Los Azules

Los Azules is one of the world’s largest undeveloped copper deposits, in San Juan, Argentina

The Los Azules valley in the Andes
Photo: McEwen Inc.
10.2 billion lb
Copper reserves, 100% basis
21 years
Mine life
46.3%
McEwen’s interest, through McEwen Copper
Mid-2027
Construction decision expected

Los Azules Feasibility Study release, Oct 7, 2025; release, Aug 27, 2026.

Gold and silverCopper

Los Azules, San Juan, Argentina, in McEwen’s 3D map

San Juan, Argentina

Los Azules holds 10.2 billion pounds of copper reserves and a 21-year mine life

204,800 tonnes of copper a year in the first five years. Cash cost US$1.71 a pound; all-in sustaining cost US$2.11, second quartile. Initial capital is US$3.17 billion. Los Azules lies about 80 km west-northwest of Calingasta and 6 km east of the Chilean border, at about 3,500 metres.

Los Azules copper, 100% basis (Feasibility Study, Oct 7, 2025)
CategoryTonnesGradeCopper
Proven and Probable reserve1.02 billion t0.45%10.2 billion lb
Measured and Indicated0.97 billion t0.26%5.4 billion lb
Inferred4.24 billion t0.21%20.0 billion lb

Los Azules Feasibility Study release, Oct 7, 2025. Resources exclusive of reserves. McEwen’s 46.3%: reserve 4,730 million lb, Measured and Indicated 2,547.4 million lb, Inferred 9,260.0 million lb (McEwen’s Reserves and Resources page).

Qualified persons: Channa Kumarage, P.Eng., Vice President, Operations (technical contents, including reserves) and Luke Willis, P.Geo., Director of Resource Modelling (resources), both Qualified Persons as defined by SEC S-K 1300 and NI 43-101 (presentation, Sept 2026, slide 2). Resources are exclusive of reserves. See the cautionary statement.

It is designed to run on 100% renewable power, with no tailings dam

Heap leach and SX-EW make copper cathode on site. The Feasibility Study puts its carbon emissions 72% lower and its water use 74% lower than conventional copper concentrators.

Los Azules Feasibility Study release, Oct 7, 2025

100%
Renewable power
0
Tailings dams
72%
Lower carbon
74%
Less water

Stellantis and Nuton, a Rio Tinto venture, own 35.4% of McEwen Copper

Stellantis owns 18.2%; Nuton owns 17.2%.

McEwen fact sheet, Sept 2026; presentation, Sept 2026, slide 16.

  • 46.3% McEwen Inc.
  • 18.2% Stellantis
  • 17.2% Nuton (Rio Tinto)
  • 13% Rob McEwen
  • 3% Victor Smorgon
  • 2.3% Others

A US$240 million term loan closed in August 2026

Sprott lent US$112 million, Rob McEwen US$85 million and others US$43 million. Societe Generale is the financial advisor for the project debt.

release, Aug 27, 2026; release, May 14, 2026.

A construction decision is expected in mid-2027

A final investment decision and full project financing is expected in mid-2027, with commercial copper cathode production targeted for 2030. The build is planned at 33 months.

release, Aug 27, 2026; presentation, Sept 2026, slide 11. Forward-looking; see the cautionary statement.

The Los Azules camp from the air

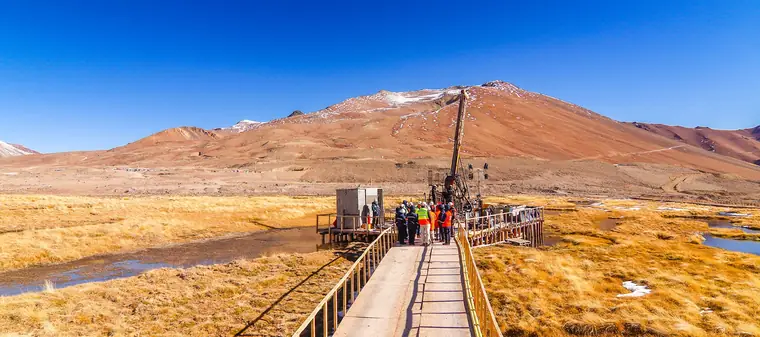

Drill rig on the boardwalk across the wetland at Los Azules
Drillers at Los Azules

Photos: McEwen Inc.
